The May 2017 work plan by Boston Water & Sewer Commission is shown below as part of Phase II of the multi-year North End Water, Sewer and Drainage Project. During May, work will continue on Hanover Avenue and Hull Street, with a new water main installation beginning on Richmond Street. This month also brings hope of several project Read More…
Tag: North End Sewer Project
North End Water and Sewer Work April 2017 Update
The April 2017 work plan by Boston Water & Sewer Commission is shown below as part of Phase II of the multi-year North End Water, Sewer and Drainage Project. During April, work will continue on Hanover Avenue, Hull Street, and Richmond Street, with new work beginning on Tilestone Street. Looking into May brings hope of several project completions on Read More…
North End Water and Sewer Works March 2017 Update
The March 2017 work plan by Boston Water & Sewer Commission is shown below as part of Phase II of the multi-year North End Water, Sewer and Drainage Project. During March, work will continue on Richmond St., Hull St. and Hanover Ave. Looking into April brings work to Tileston St. Contact information and scheduling for the upcoming Read More…
North End Water and Sewer Work February 2017 Update
The February 2017 work plan by Boston Water & Sewer Commission is shown below as part of Phase II of the multi-year North End Water, Sewer and Drainage Project. Contact information and scheduling for the upcoming month of construction are included. The second page details all remaining work with a projected timeline.
North End Water and Sewer Work Continues in January 2017
The January 2017 work plan by Boston Water & Sewer Commission is shown below, as part of Phase 2 of the multi-year North End Water & Sewer Project, including contact information and scheduling details. The second page shows the impacted streets that will continue for the next couple of years.
Water and Sewer Work Continues on North Street, North Square & Sheafe Street
The December 2016 work plan by Boston Water & Sewer Commission is shown below, as part of Phase 2 of the multi-year North End Water & Sewer Project. Here is the latest update from Boston Water & Sewer Commission, including contact information and scheduling for the upcoming month of construction work. For December 2016, a completely new 12″ Read More…
North End Water & Sewerage Works November 2016 Update
Phase 2 of the North End Water & Sewer Project is underway. Here is the latest update from Boston Water & Sewer Commission, including contact information and scheduling for the upcoming month of construction work. For November 2016, a new 12″ sewer main will be installed at North Square including the temporary removal of some Read More…
North End Water & Sewer Project to Begin Multiyear Phase 2

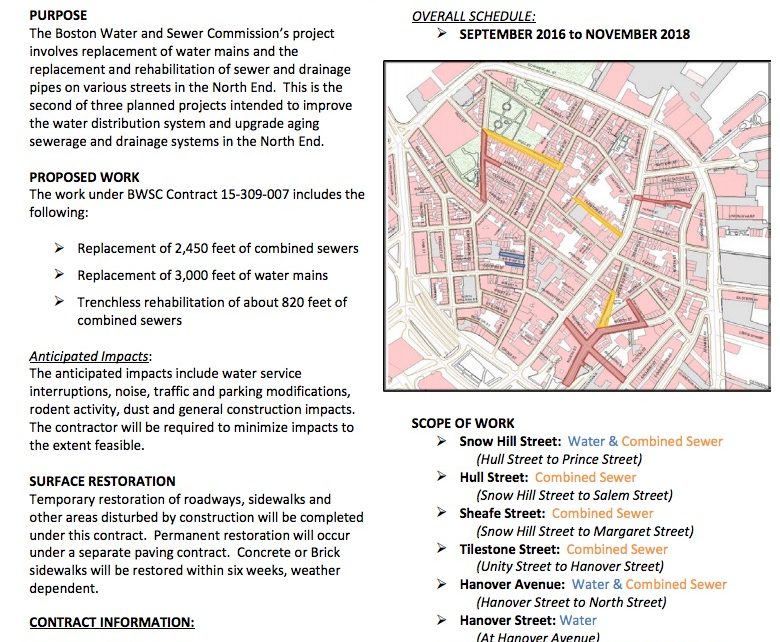

The North End Sewer and Water Project is entering Phase 2 in the Fall 2016, moving off the main drag on Hanover Street to the more residential parts of the North End. This is the second of three planned project phases in the neighborhood intended to improve water distribution and upgrade failing sewer and drainage Read More…
North End Water & Sewer Project Update for November 2015

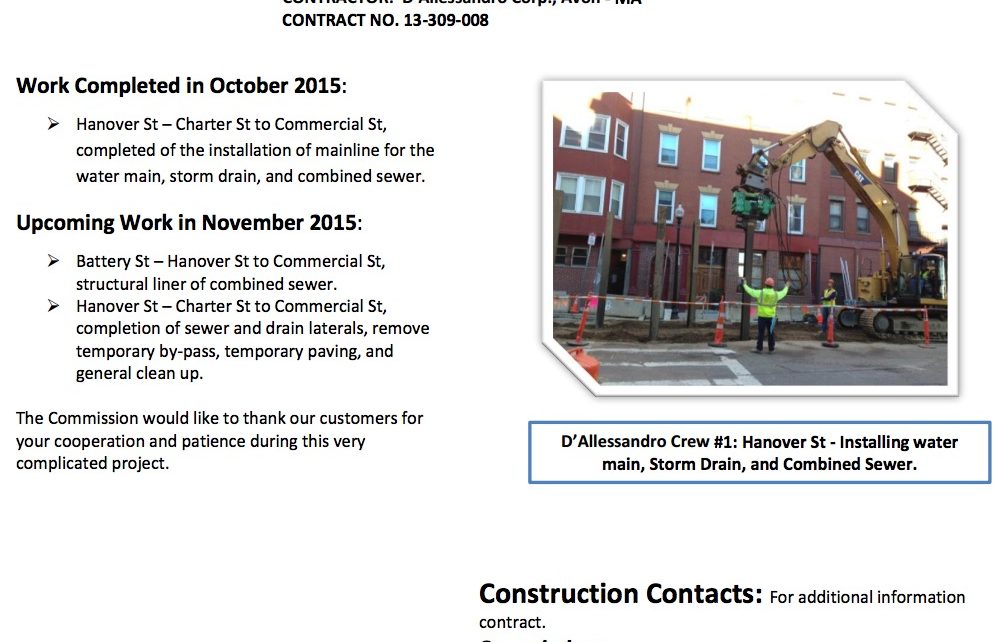

Boston Water & Sewer Commission (BWSC) is providing the following update and schedule for the major sewer and water main project underway in the North End. In October 2015, a new water main, storm drain and combined sewer were completed on Hanover Street, between Charter and Commercial Street. Coming in November 2015, BWSC will be working on Battery Read More…
North End Water & Sewer Project Plan for September 2015
Boston Water & Sewer Commission (BWSC) is providing the following update and schedule for the major sewer and water main project underway in the North End. In September 2015, most work will occur on Battery and Hanover Streets. The BWSC North End project will continue through 2016. Contact numbers are included below for residents and businesses that have Read More…
Water & Sewer Project Plan for August 2015

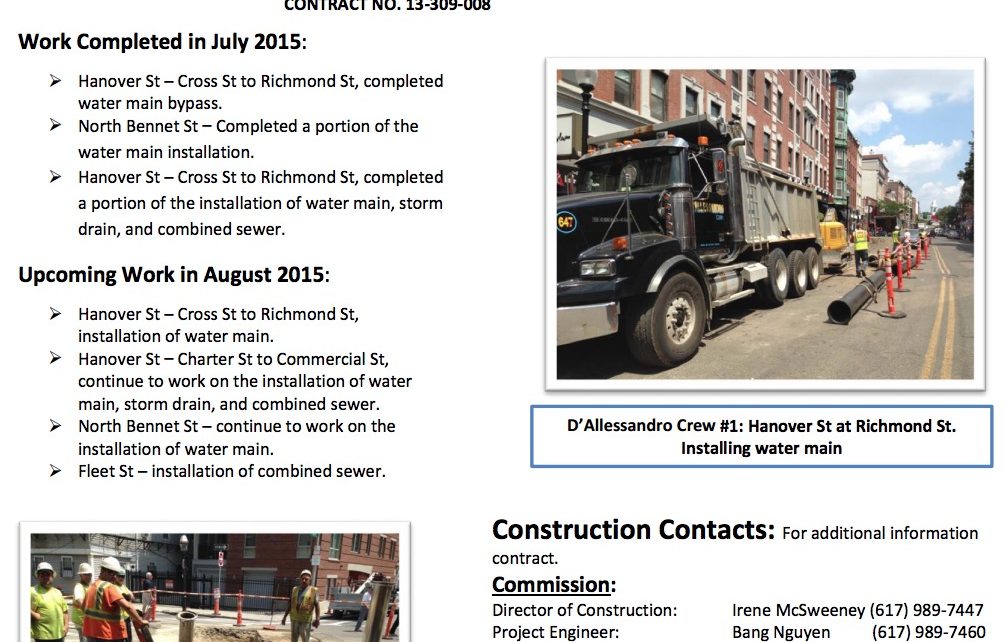

Boston Water & Sewer Commission (BWSC) provides the following update and schedule for the major sewer and water main project underway in the North End. In August 2015, most work will occur on Hanover, N. Bennet and Fleet Streets. The BWSC North End project will continue through 2016. Contact numbers are included below for residents and businesses Read More…
